Ben Collier, PhD Book a call →free, 15 minutes

Carnegie Mellon University in Qatar · 2012 to 2016 · Undergraduate

Business Technology Consulting

How consultants think, how they interview, and how technology projects get built and managed.

15 students in 2014 and 7 in 2015

I built this course for CMU Qatar from an older systems analysis and design course, and turned it toward both sides of consulting: the business analysis that consulting firms hire for, and the technology work of designing and running a project. The first half was frameworks and case interviews, with cases on consulting firms and live practice cases like Harley-Davidson and a fighter jet division. The second half ran a change management simulation and then moved into the systems development life cycle, UML, agile, and project management. Students in Business Administration, Information Systems, and Computer Science took it together, and it was built to get them ready for a first-round interview at firms like McKinsey, BCG, Accenture, and Bain.

  • Spring 2014
  • Sundays and Tuesdays
  • Course number 70-453

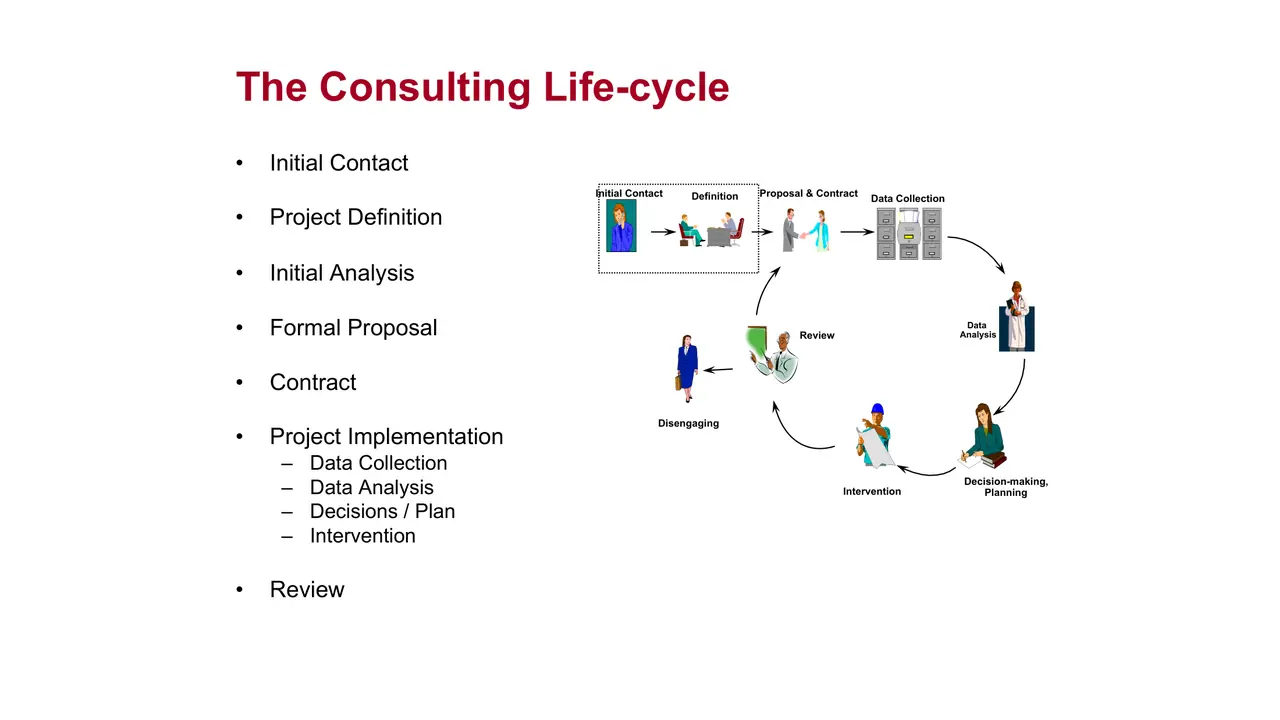

Slide: The consulting life cycle, from first contact to review

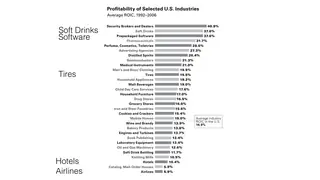

Slide: Profitability of US industries, from soft drinks at the top to airlines at the bottom
Slide: Integrated project management with the project leader at the center

slides from the decks
I taught from

Spring 2014 · Sundays and Tuesdays

Week by week

Scroll the schedule and the slides follow along: five from each session, picked from the decks I taught from.

  1. Part I: The consulting business

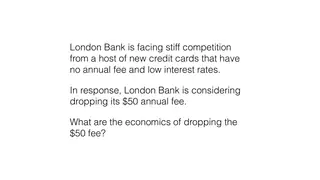

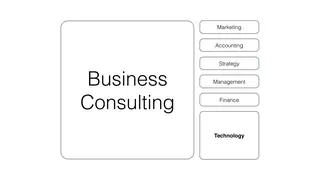

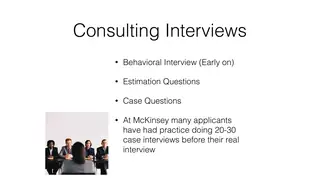

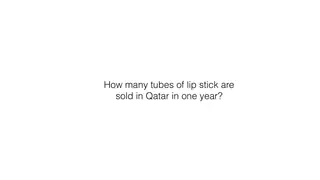

  2. W1Introduction and course overviewThe consulting life cycle, from first contact to reviewBusiness consulting spans marketing, accounting, strategy, management, finance, and technologyThree kinds of consulting interview questions: behavioral, estimation, and caseEstimation warm-up: how many tubes of lipstick are sold in Qatar in a year?London Bank: what are the economics of dropping a $50 annual fee?

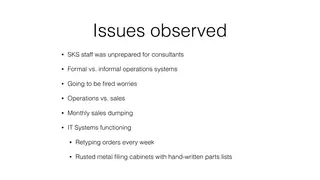

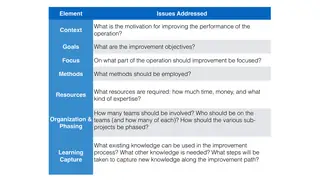

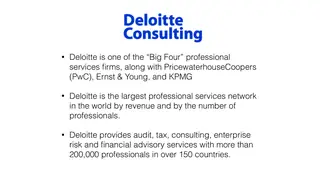

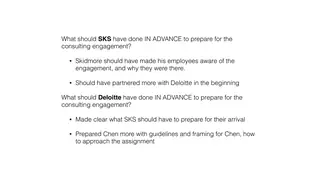

  3. W1Case: Deloitte & Touche Consulting GroupCaseDeloitte, the largest professional services network in the worldA framework for any engagement: context, goals, focus, methods, resourcesThe framework filled in for Deloitte's engagement at SKSWhat went wrong at SKS: retyped orders and hand-written parts listsWhat client and consultant should each have done before the engagement started

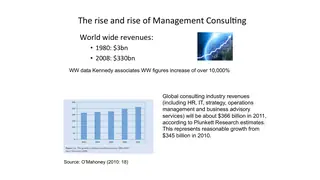

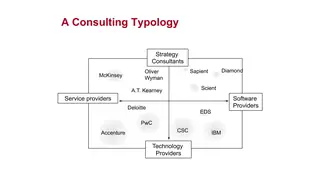

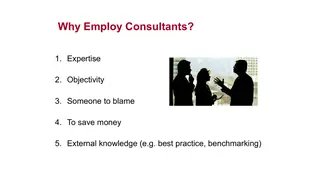

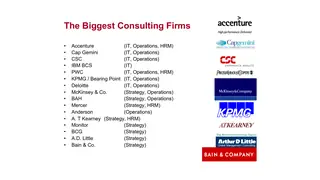

  4. W2Overview of consulting: firms, roles, and skillsThe biggest consulting firms and what they sellA consulting typology: strategy firms, service providers, and technology providersManagement consulting grew from $3 billion in 1980 to $330 billion in 2008Strategy versus IT consulting in the professional services marketWhy employ consultants? Expertise, objectivity, and someone to blame

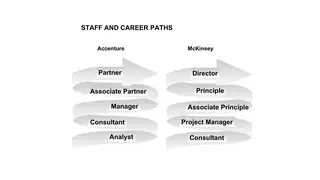

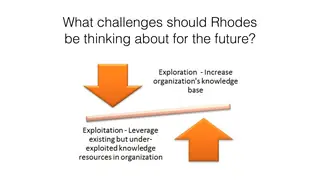

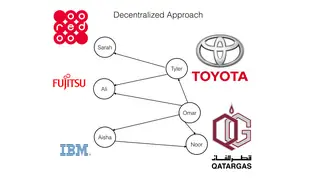

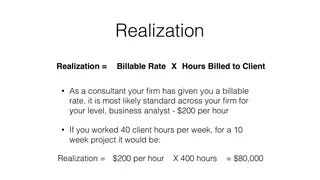

  5. W2Case: Innovation at the Boston Consulting GroupCaseCareer ladders at Accenture and McKinseyUtilization: hours billed over hours workedRealization: billable rate times hours billedDecentralized innovation: knowledge built across client projectsBCG's choice between exploring new knowledge and exploiting what it has
  6. Part II: Business analysis with consulting frameworks

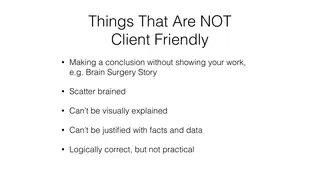

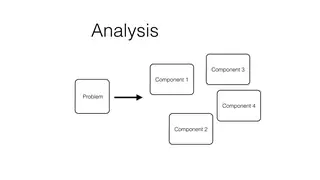

  7. W3Business analysis using consulting frameworksWarm-up case: is Volvo really the safest car in America?Frameworks are like knowing the anatomy before you operateThings that are not client friendlyAnalysis: break the problem into its componentsSegment your numbers: which segments are losing revenue?

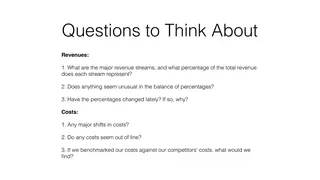

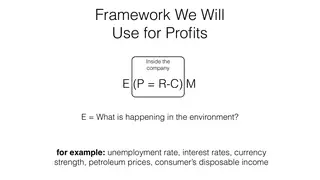

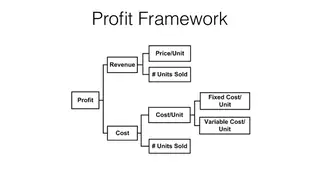

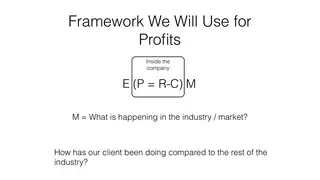

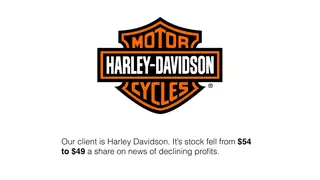

  8. W3Profitability framework: Harley-DavidsonCaseThe profit frameworkE(P = R - C)M: start with the environmentThen the market: how is the client doing against its industry?Questions to ask about revenues and costsHarley-Davidson's stock fell from $54 to $49 on news of declining profits

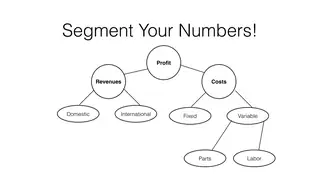

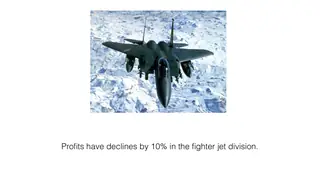

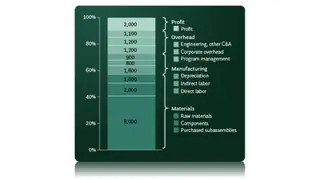

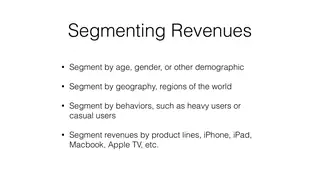

  9. W4Profitability: the fighter jet case and segmentingCaseThe Feb 2 session was cancelledSegment profit into revenues and costs, then keep goingWays to segment revenueWays to segment costsProfits have declined 10% in the fighter jet divisionWhere the cost of a fighter jet goes

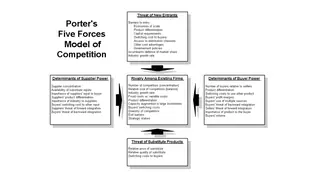

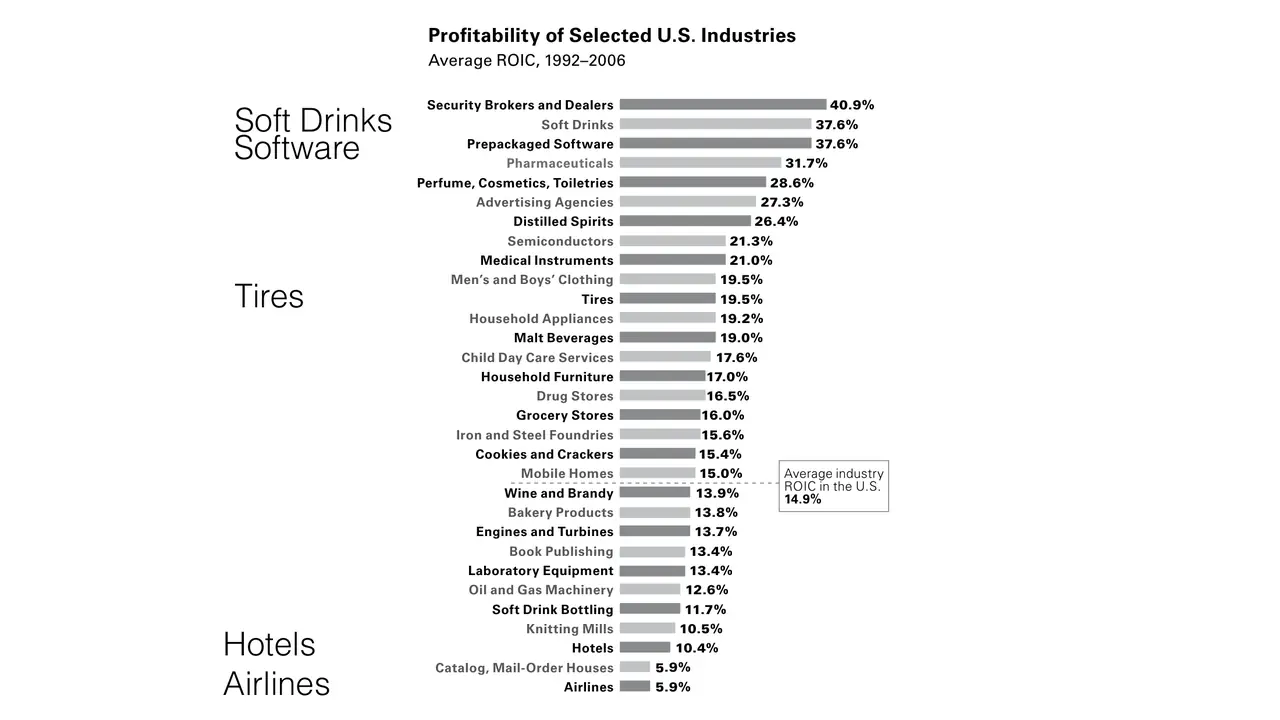

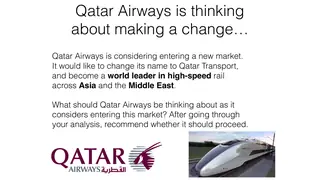

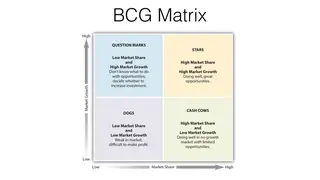

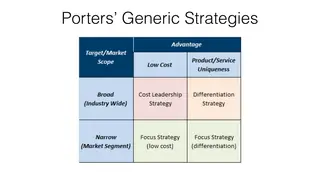

  10. W5Strategy frameworks: Porter, SWOT, and BCGShould Qatar Airways become Qatar Transport and build high-speed rail?Porter's generic strategiesProfitability of US industries, from soft drinks at the top to airlines at the bottomPorter's five forcesThe BCG matrix

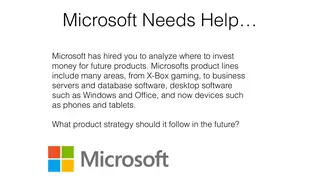

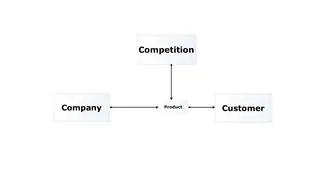

  11. W6The business situation frameworkMicrosoft needs help: where should it invest next?Company, competition, customer, and productThe business situation framework in fullThe mergers and acquisitions fit frameworkThe capacity change framework
  12. W6Case: retail banking in Southeast Asia, with a guest speakerCase
  13. Part III: Managing change

  14. W9Change management simulation: low urgencyIn-class exerciseThe fundamentals of business consulting so far, case by caseWhat's next: change management, IT methods, and project managementChange the minds of 20 people in 96 weeks

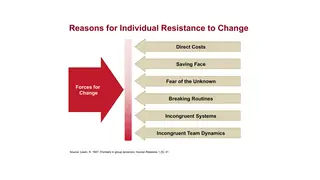

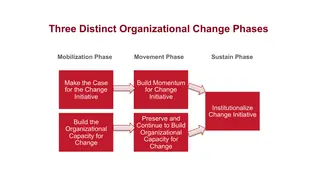

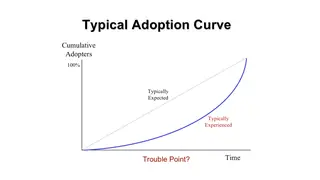

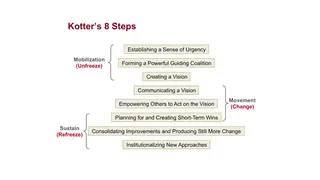

  15. W9Change management simulation debriefThree phases of organizational change: mobilize, move, sustainKotter's eight stepsWhy individuals resist changeThe typical adoption curve, and where it gets into troubleA strategy for change: who has power and who resists
  16. W10Change management simulation: high urgencyIn-class exercise

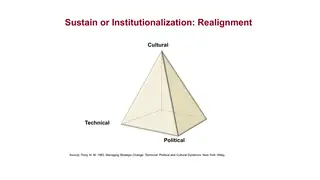

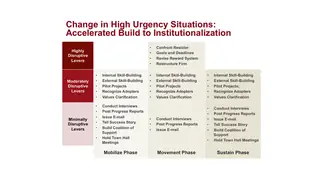

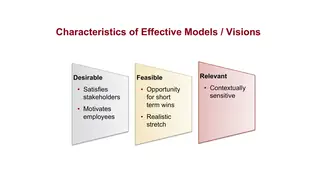

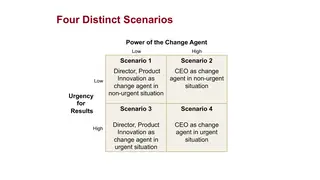

  17. W10Change management: context, vision, and paceFour scenarios: how much power the change agent has, and how urgent the change isReactive change closes a performance gap, proactive change an opportunity gapWhat makes a vision work: desirable, feasible, relevantIn urgent situations, the build to institutionalization is fasterSustaining change means realigning the technical, political, and cultural
  18. Part IV: IT consulting methods and project management

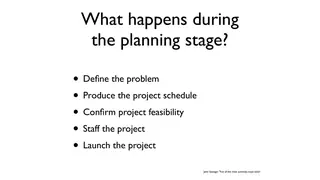

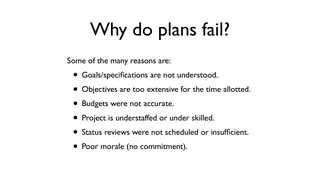

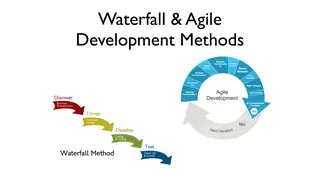

  19. W11Systems analysis and design: the SDLCWhat happens in the planning stageWhy plans failThe security auditWaterfall and agile developmentFeature creep

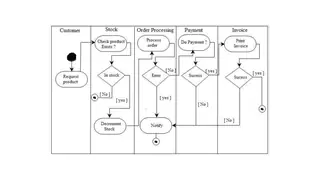

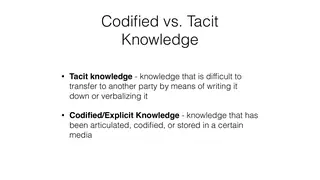

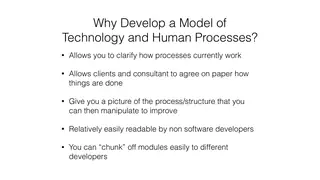

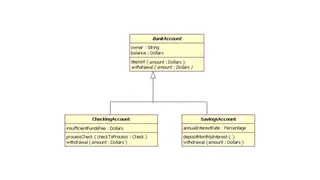

  20. W12Unified Modeling Language: use cases, activities, and classesWhy model technology and human processes at all?Codified versus tacit knowledgeA use case diagramAn activity diagram with swim lanes for an orderA class diagram for bank accounts
  21. W12IT security, guest lecture
  22. W13Agile versus waterfallThe deck is almost entirely embedded video

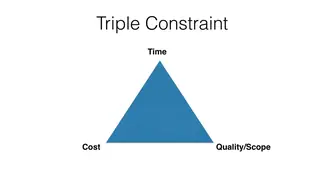

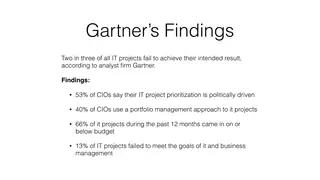

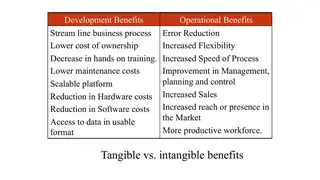

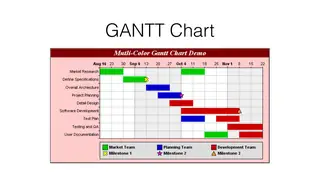

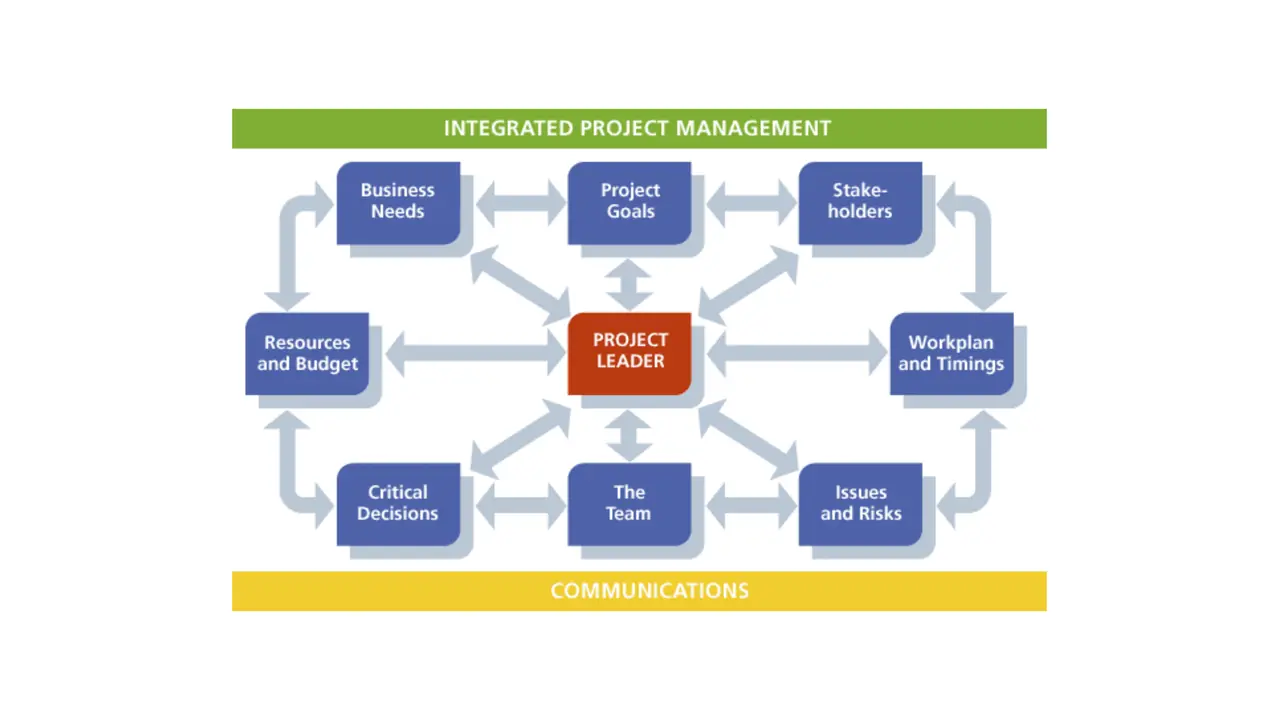

  23. W14Project managementIntegrated project management with the project leader at the centerThe triple constraint: time, cost, and scopeA Gantt chartGartner: two in three IT projects fail to achieve their intended resultDevelopment and operational benefits, tangible and intangible
  24. W15Review

What students hand in

Major assignments

Case interviews

In 2015, each student prepared two interview scripts, ran four case interviews with a partner (two as interviewer, two as candidate), and wrote a three to five page analysis of strengths and improvements for each. A second round followed with a new partner, then a case interview and a behavioral interview with me.

Client project

Teams in 2015 worked through a full engagement for a client inside the university: a client interview graded against a rubric, a five to eight page proposal with a work breakdown structure and cost estimate at set daily rates, a technical design in UML, a user interface design, and a working prototype.

Final consulting project

In 2014, small groups chose a real organization and applied the course frameworks (profit, business situation, SWOT, Porter) to a problem it faced, presented during the final exam period.

Simulations

A change management simulation, run once in a low-urgency and once in a high-urgency scenario, plus project management and strategy simulations in 2015.

Exams

Closed-book exams, one-third short answer and two-thirds consulting case analysis. In 2014 the midterm and final were 30% and 40%; in 2015 a single final was 20%.

What students built

Student work

Every project, by term.

Spring 2014: final consulting projects 5 projects
  • Vodafone Qatar. Looked at Vodafone's launch of Falla, the first Qatari telecom plan aimed at young people, and asked which youth products and services Vodafone should focus on to position itself against Ooredoo. Porter's five forces and a youth-market strategy
  • Zara. Analyzed Zara's vertically integrated, fast-turnover model, including its single distribution center and weak online presence, and recommended where it should grow next. Business situation framework and SWOT
  • A GCC charity supporting Syrian refugees. The charity raised most of its money through events, an unstable source. The team estimated its revenues and costs and recommended ways to increase donations and build a steadier income. Profit framework, SWOT, and business situation framework
  • A yoga studio in Doha. Asked how the studio could grow with the market, cross-sell, and attract new customers, and recommended partnerships with sports and hotel facilities, corporate yoga, and better merchandising. SWOT, competitive comparison, BCG matrix, and Porter's five forces
  • A long-established Doha electronics and video game retailer. Compared revenue and costs from 2011 to 2012, and weighed small stores, limited capital, and the shift to digital games against the store's reputation and locations. Profit analysis from interviews with the general manager and an accountant
Spring 2015: client technology projects 2 projects
  • Visualizing Twitter for academic assessment. A tool to pull a Twitter stream by search term, sort it into threads, and let an instructor grade students' contributions to discussion outside class. Client interview, proposal, UML design, UI design, prototype
  • Digitizing negotiation exercises. A web platform, aimed at the iPad, for running classroom negotiation exercises like New Recruit so that results and scoring are immediate instead of done on paper. Client interview, proposal, UML design, UI design, prototype

In their words

What students say

4.65 out of 5 average teaching rating · 2 sections · 20 student responses · all evaluations

Great instructor and treats us as professionals not only students

Spring 2015

One of the things I enjoyed the most about this course is the simulations aspect in the last module. I would recommend anyone to take a course with professor Collier.

Spring 2015

Very wonderful course that taught me what is consulting

Spring 2014

Offerings

When I taught it

  • Spring 2014
  • Spring 2015

All courses
